The mezzanine installation timeline: week-by-week
From signed contract to operational mezzanine, expect 8 to 20 weeks. Here's the week-by-week breakdown of permits, steel fabrication, site prep, installation, and inspections.
Editorial team

A typical industrial mezzanine project takes 8 to 20 weeks from signed contract to operational use, depending on permit timelines, fabrication backlogs, and project size. Most facilities plan poorly for the front-loaded permit phase — they're surprised to learn that 60% of the total timeline can be spent waiting on permits and shop drawings before any steel arrives.
This is the realistic week-by-week breakdown, with where typical projects slip and how to compress the timeline.

Project phase summary
| Phase | Typical duration | What's happening |
|---|---|---|
| 1. Pre-design (engineering, site assessment) | 1–3 weeks | Engineer review, slab analysis, fire protection review |
| 2. Permit application + review | 2–8 weeks | Drawings submitted, AHJ review |
| 3. Steel fabrication | 4–8 weeks | After permit approval, steel is cut, drilled, painted |
| 4. Site preparation | 1–2 weeks | Pre-install: clear area, mark column locations, mobilize |
| 5. Installation | 1–4 weeks | Steel erection, decking, railings, stairs |
| 6. Inspections + finishes | 1–2 weeks | Building inspections, sprinkler additions, finals |
| Total | 10–27 weeks | (median ~14 weeks for a standard 2,000 sqft project) |
Week-by-week walkthrough
Weeks 1–3: Pre-design and procurement
Once you've selected a vendor and signed the contract:
- Site assessment — vendor or engineer visits, measures clear heights, checks slab condition, reviews existing fire protection
- Structural engineering review — designs columns, beams, joists for your specific use case and code load requirements
- Drawings produced — stamped structural drawings, fire protection plans, electrical plans (if added lighting/outlets), accessibility compliance
This phase often happens in parallel with finalizing the purchase order. Vendors typically need 2–3 weeks for engineering even on a "stock" mezzanine, longer for custom configurations.
Risk: Slab assessment that surfaces problems (insufficient capacity, hidden voids, drainage interferes with column locations) — can add 2–4 weeks for design rework.
Weeks 2–10: Permit application + review
Submitted to the local building department, the AHJ reviews drawings against IBC, fire code, accessibility code, and any local amendments.
- Permit fees paid: typically 1–3% of construction value
- Plan review by structural plans examiner, fire protection reviewer, accessibility reviewer
- Correction letters issued if drawings need changes (very common — 70% of projects get at least one round)
- Final permit issued when all reviewers sign off
Permit review timelines by region (typical 2026 ranges):
| Region | Standard review timeline |
|---|---|
| US South (TX, FL, GA, NC) | 2–4 weeks |
| US Midwest | 2–5 weeks |
| US Northeast (excluding NYC) | 3–6 weeks |
| US West (excluding California) | 2–5 weeks |
| California | 6–12 weeks (CBC review, often multiple cycles) |
| NYC | 8–16 weeks (NYCBC + DOB approvals) |
| Canada (most provinces) | 3–6 weeks |
| Canada (Toronto, Vancouver metros) | 4–8 weeks |
This is the most-slipped phase. Plan to it generously.

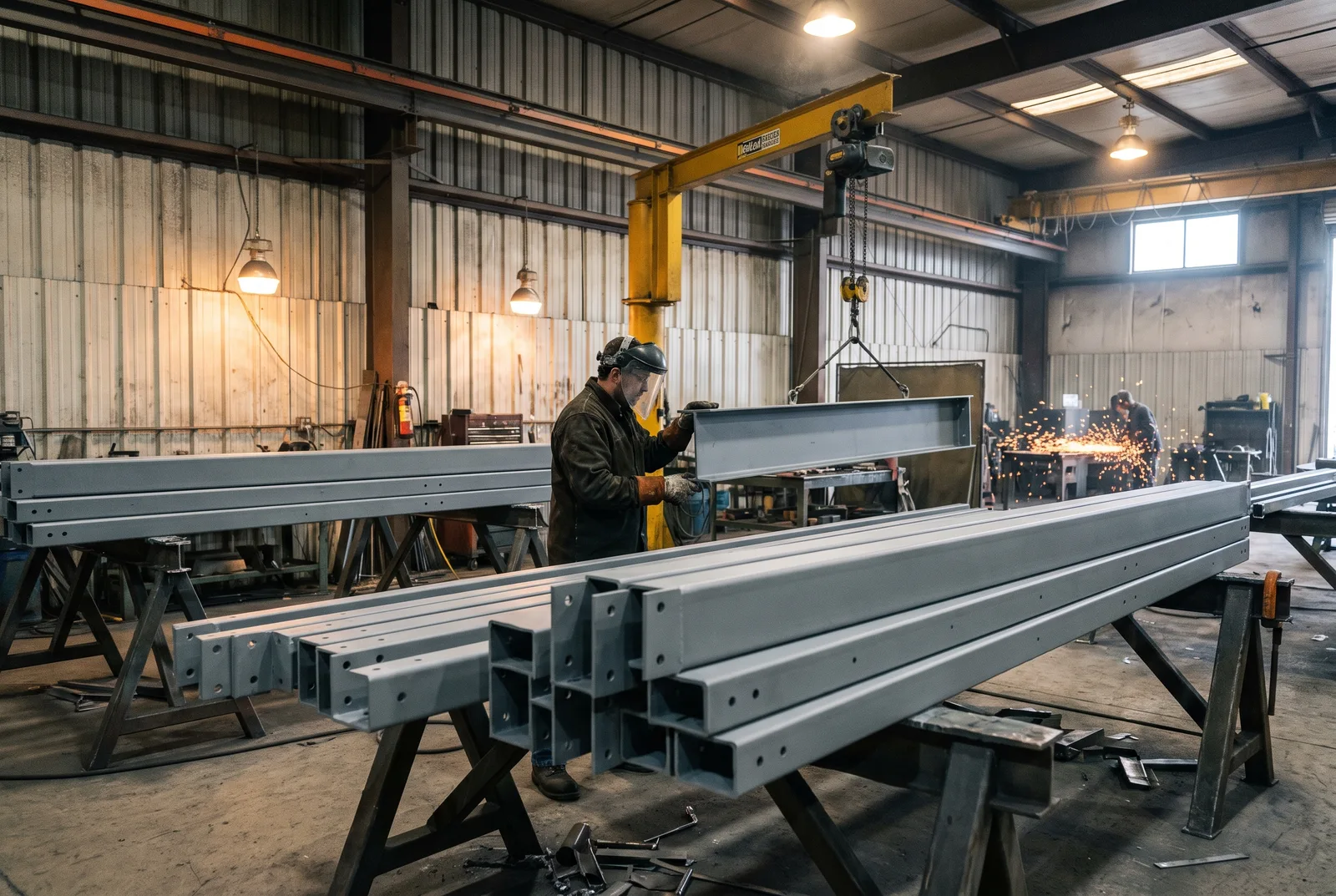

Weeks 6–14: Steel fabrication
Begins after permits are issued — vendors typically won't cut steel against unpermitted drawings because corrections can require rework.
- Steel procurement — primary steel from mill or warehouse, deck stock from supplier
- Shop fabrication — cutting, drilling, welding, painting
- Quality control — fabrication shop verifies against drawings
- Ready-to-ship notification
Standard fabrication: 4–6 weeks for off-the-shelf configurations using common steel sizes. 6–10 weeks for custom configurations or unusual sizes. Steel mill backlogs in 2024–2026 have extended this from historical norms of 3–5 weeks.
Risk: Steel price changes during fabrication for projects with floating pricing. Lock in pricing at contract signing where possible.

Weeks 14–16: Site preparation
In the week or two before installation:
- Operations team clears the install area — empties storage, moves pallets, relocates equipment
- Slab marked for column locations

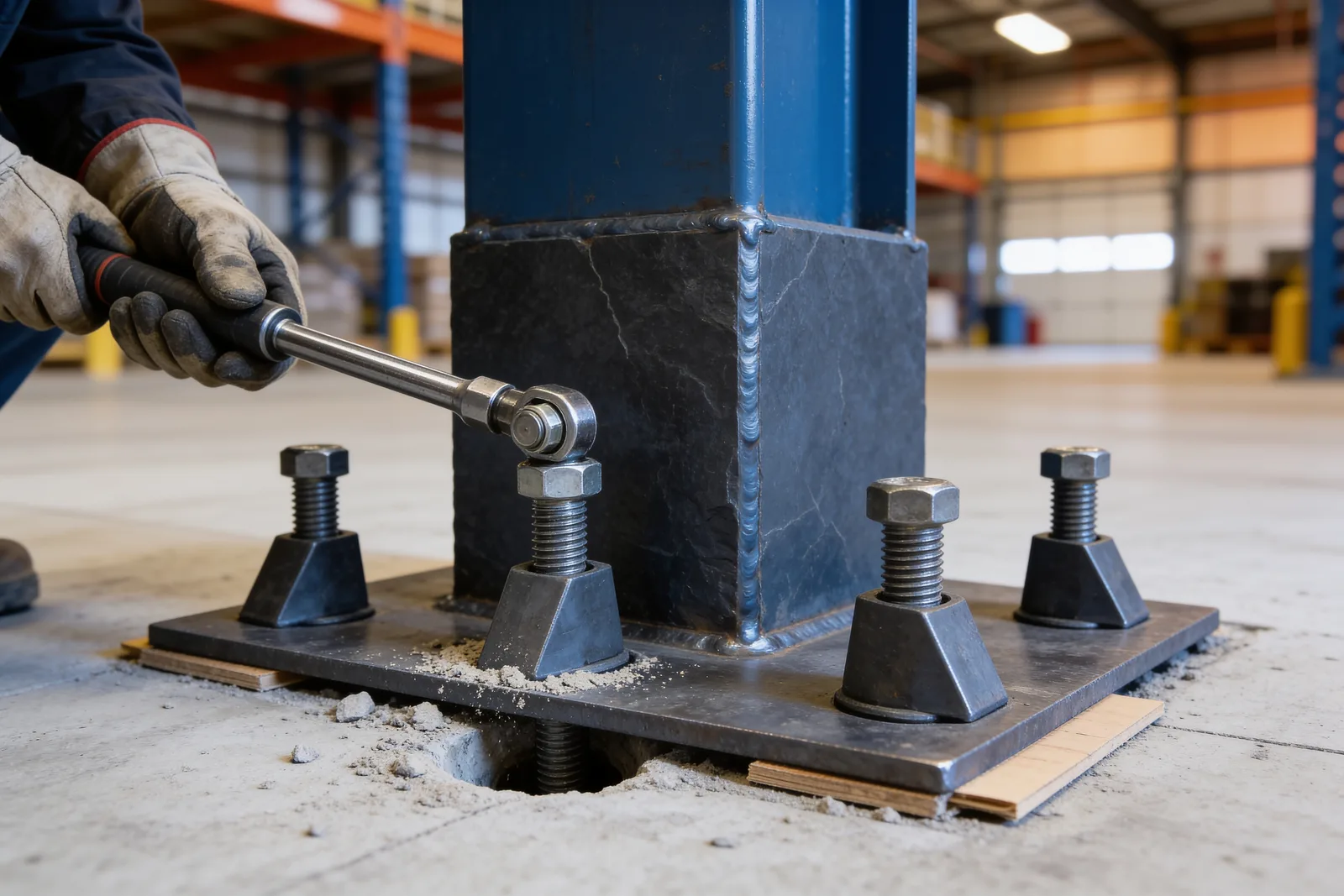

- Anchor holes drilled (if epoxy-set anchors required by slab condition)
- Power and lighting verified for installation crew
- Equipment mobilized — forklift or telehandler if vendor doesn't bring one, scissor lifts for high steel work
- Pre-install meeting between vendor crew lead and facility manager — confirms scope, safety plan, working hours, ingress/egress
A frequent operational mistake: scheduling installation for a busy operational period. Even a "minimal disruption" install creates noise, dust, and an obstacle. Plan around peak shipping or production windows.

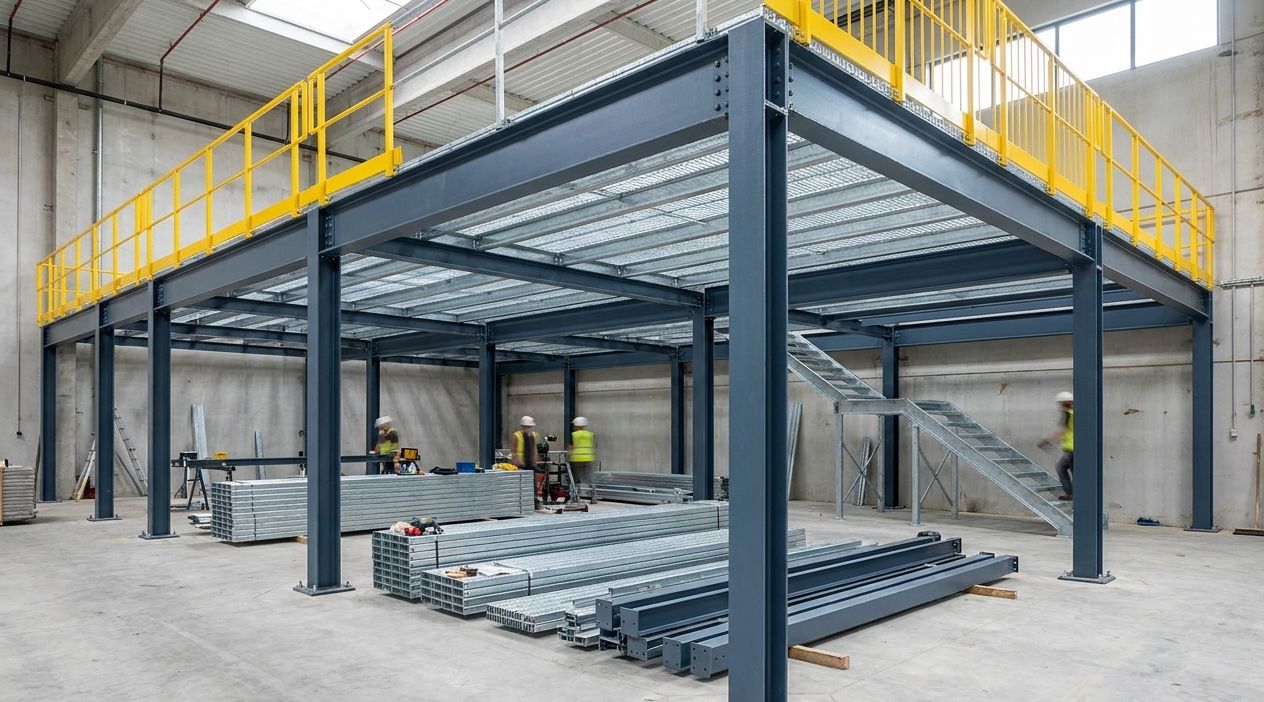

Weeks 14–18: Installation
The actual mezzanine going up. Sequence for a standard 2,000 sqft free-standing mezzanine:

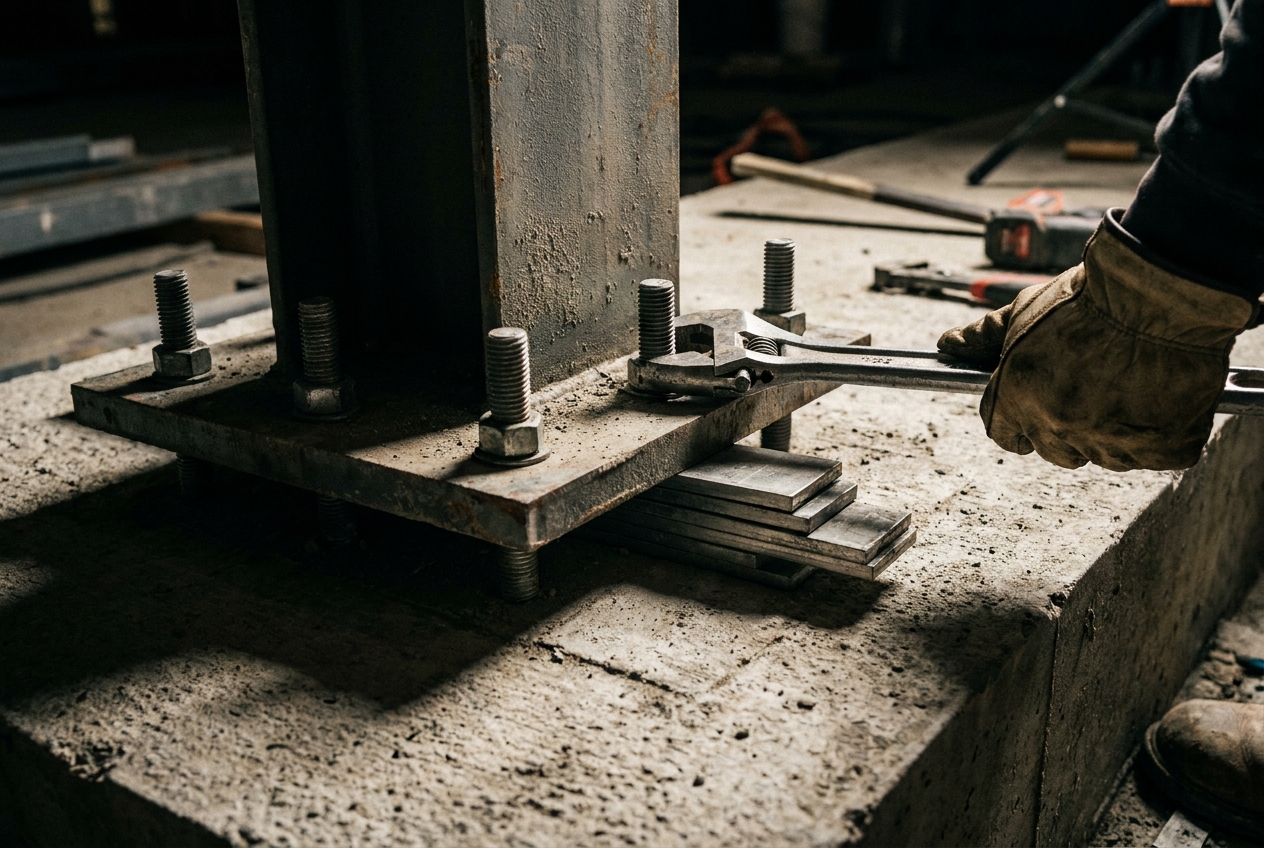

- Day 1–2: Column placement and anchoring. Slowest part of the install — each column gets surveyed, anchored, plumbed.

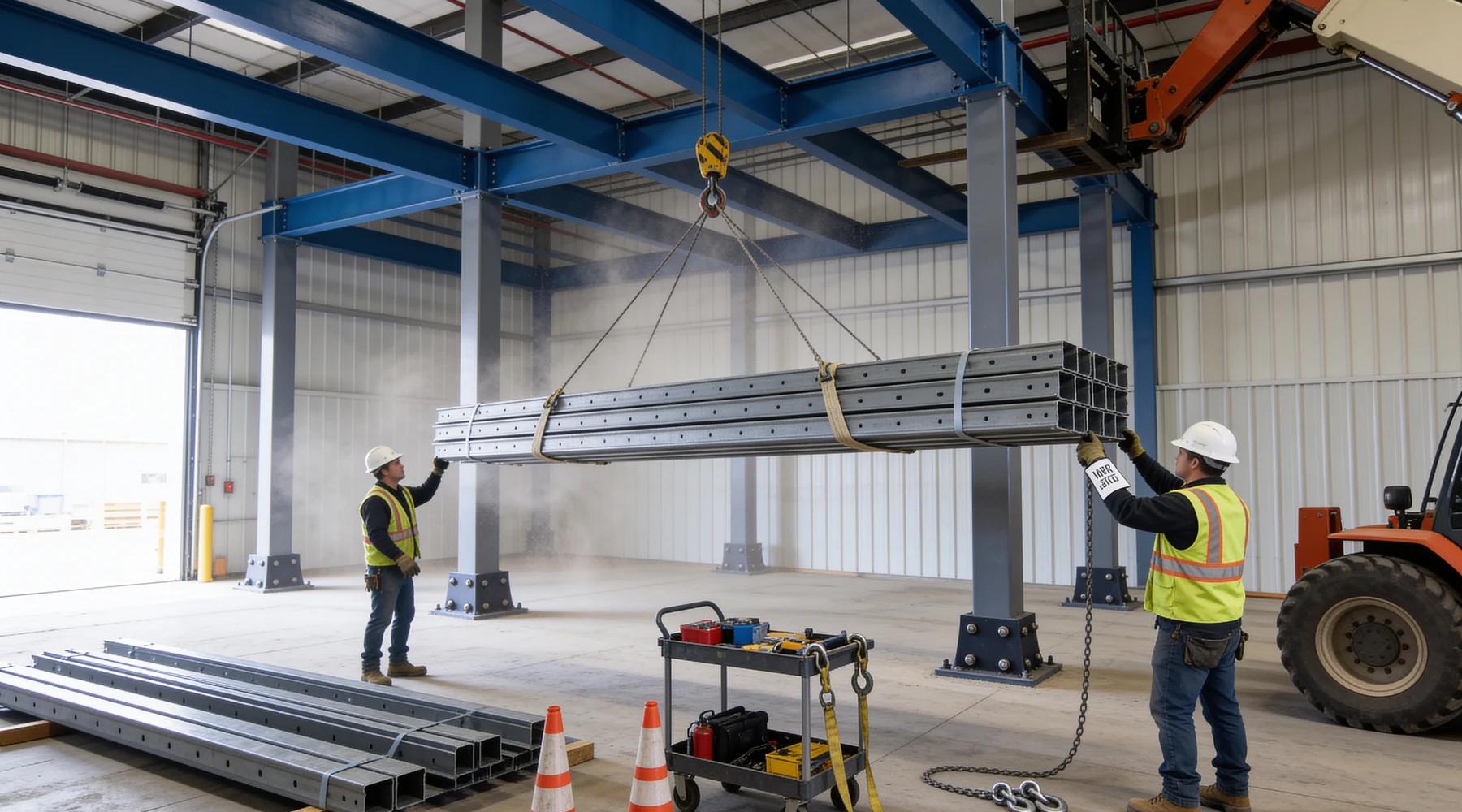

- Day 2–4: Primary beams installed on columns. Crane or telehandler lifts beams; crew bolts to columns.
- Day 4–6: Joists installed across beams. Faster work — bolted connections, mostly mechanical.
- Day 6–8: Decking installed. Bar grating drops in quickly (1–2 days). B-deck and concrete pour takes longer (4–7 days including cure time).
- Day 8–10: Railings, stair towers, safety gates installed.
- Day 10–12: Final tightening, punch-list items.
Total install time for a standard 2,000 sqft mezzanine: 2–3 weeks. Larger or more complex projects scale roughly linearly.
Weeks 16–18: Inspections and finishes
- Building inspection of foundation/anchors, structure complete, and finals
- Fire protection inspection if sprinkler additions were required
- Accessibility inspection of stairs, handrails, signage
- Final electrical inspection if power was added
- Certificate of occupancy updated to reflect new floor area
Inspections are scheduled by the vendor or contractor with the AHJ — typically takes 3–5 business days per inspection to schedule.
Risk: Failed inspection means rework + re-inspection scheduling. Plan a 1-week contingency for at least one re-inspection cycle on the first project.
Typical total project timelines
For planning purposes:
| Project size & complexity | Realistic total timeline |
|---|---|
| Small (500–1,500 sqft, simple, low-permit jurisdiction) | 8–12 weeks |
| Medium (2,000–5,000 sqft, standard config) | 12–16 weeks |
| Large (5,000+ sqft, custom, dense jurisdiction) | 16–24 weeks |
| Complex (heavy load, integrated with existing building) | 20–32 weeks |
If a vendor quotes "we can have this installed in 4 weeks," ask specifically about the permit phase. Either they're shortcutting permits (which becomes your problem at next inspection or insurance audit) or they're not counting that phase in the timeline.
How to compress timelines
The legitimate ways to speed up a mezzanine project:
- Start permit application before final design lock. Submit preliminary drawings to start the review clock; refine during review.
- Order long-lead steel concurrently with permit submission. Risky — corrections may require steel rework — but for off-the-shelf sizes the risk is low.
- Pre-build subassemblies off-site. Stair towers especially can be welded as one unit and lifted into place in hours.
- Schedule installation during a low-activity facility window — overnight, weekends, scheduled shutdown. Reduces operational disruption even if total install days don't change.
- Use a vendor with in-house engineering and fabrication. Cuts handoffs between firms; tighter coordination.
What doesn't work:
- Pressuring AHJ to expedite review without paying expedite fees (and not all jurisdictions offer them)
- Skipping inspections — fails at refinancing, sale, or insurance audit later
- Using unpermitted "equipment platform" classification to bypass mezzanine permitting (works for some installations, but only when genuinely applicable — see mezzanine vs work platform)
